Peripheral Ring Road 2 (PRR-2) Final Notification 2026: Route, Villages & What It Means for Buyers
After two decades of preliminary notifications and disputes, the PRR-2 (Bengaluru Business Corridor) final notification is out. Here is what it covers, the notification history, and what it means if you own or are buying land along the alignment.
Peripheral Ring Road 2 (PRR-2) is a planned eight-lane arterial corridor forming part of Bengaluru's larger ring-road network, the Bengaluru Business Corridor. In September 2026, the government issued the final notification acquiring about 1,427.34 acres across roughly 31 villages for a ~52 km stretch linking Mysuru Road with Hosur Road. The road is planned at 65 metres wide within a 100-metre corridor, with service roads, cycle tracks and footpaths. Together with the northern PRR-1 (Tumkur Road to Hosur Road), it is meant to complete a ring of about 125 km around the city.
Key takeaways
- PRR-2 received its final land-acquisition notification in September 2026 — a major milestone after ~20 years
- The notification covers about 1,427.34 acres across roughly 31 villages
- The corridor is 8-lane, 65 m wide within a 100 m width, linking Mysuru Road to Hosur Road (~52 km)
- It went through preliminary notifications around 2005 and 2006 before this final one
- If your land is inside the alignment, acquisition and compensation/TDR follow — verify your survey number
- The exact on-ground alignment can still shift; always confirm against the official BDA notification
Few infrastructure projects in Bengaluru have been talked about for as long, and delivered as little, as the Peripheral Ring Road. Landowners on the southern belt have lived under the shadow of preliminary notifications for close to two decades — unable to sell freely, unsure whether their land would be taken. The September 2026 final notification for PRR-2 changes that. It is the legal step that turns "proposed" into "being acquired," and it matters enormously whether your plot sits inside the line or just outside it. Here is a clear, honest breakdown.
What is PRR-2 (Bengaluru Business Corridor)?
The naming around this project is genuinely confusing, so let's clear it up first. The overall vision is a ring road around Bengaluru, branded the Bengaluru Business Corridor (BBC), built in parts. The northern arc — often called PRR-1 — is the ~73–74 km, eight-lane expressway connecting Tumkur Road to Hosur Road via Ballari Road and Old Madras Road. The southern arc — PRR-2 — is the roughly 52 km stretch that connects Mysuru Road to Hosur Road, closing the loop. Together they are intended to form a ring of about 125 km, working alongside NICE Road to divert traffic away from the city core.
PRR-2 is designed as a modern arterial road: eight lanes, a carriageway of about 65 metres inside a 100-metre corridor, with service roads, cycle tracks and pedestrian paths. The purpose is simple — give the fast-growing southern and western fringes a high-capacity bypass so they are no longer forced through congested city arteries.
The notification history: 2005, 2006 and 2026
To understand why the 2026 notification is such a big deal, you have to understand what came before it. PRR-2 has a long, messy notification trail, and this history is exactly why so many landowners are confused about their status.
| Stage | Year | What happened |
|---|---|---|
| Preliminary notification | ~2005 | An early alignment and village list were notified. Many parcels were flagged but never taken. |
| Preliminary notification (revised) | ~2006 | A revised alignment and village list followed, partly to avoid conflicts with sensitive areas. Some 2005 parcels stayed under a cloud. |
| Final notification | 2026 | The legally binding acquisition notification for ~1,427.34 acres across ~31 villages. Parcels outside it are effectively released; parcels inside it move toward acquisition. |
Between those dates, the project was stalled by land-acquisition disputes, litigation, funding gaps, and repeated tendering. A preliminary notification is only an intent to acquire; it is the final notification that carries legal weight and triggers the award and compensation process. For owners whose parcels were flagged in 2005 or 2006 but are not in the 2026 final list, this is genuine relief — their land is effectively freed. For those whose parcels are in the final list, the acquisition is now real.
What the 2026 final notification actually means
The final notification is a legal instrument, not a map you can eyeball. It lists specific survey numbers and the exact extent of land being acquired in each of the roughly 31 villages, totalling about 1,427.34 acres. If a survey number appears in it, that portion of land is being acquired for the corridor, and the owner enters the compensation / Transfer of Development Rights (TDR) process.
Two cautions matter here. First, do not rely on second-hand village-by-village lists circulating online — the only authoritative source is the official BDA gazette notification. Numbers quoted in videos and forums often mix up the 2005, 2006 and 2026 rounds. Second, even a final notification can see route refinements at the cloverleaf and junction points, and additional parcels can be notified later. Treat the current alignment as firm-but-not-frozen.
The PRR-2 alignment runs through the Nadaprabhu Kempegowda Layout (NPKL) belt — seen on TalkingLands Insights.

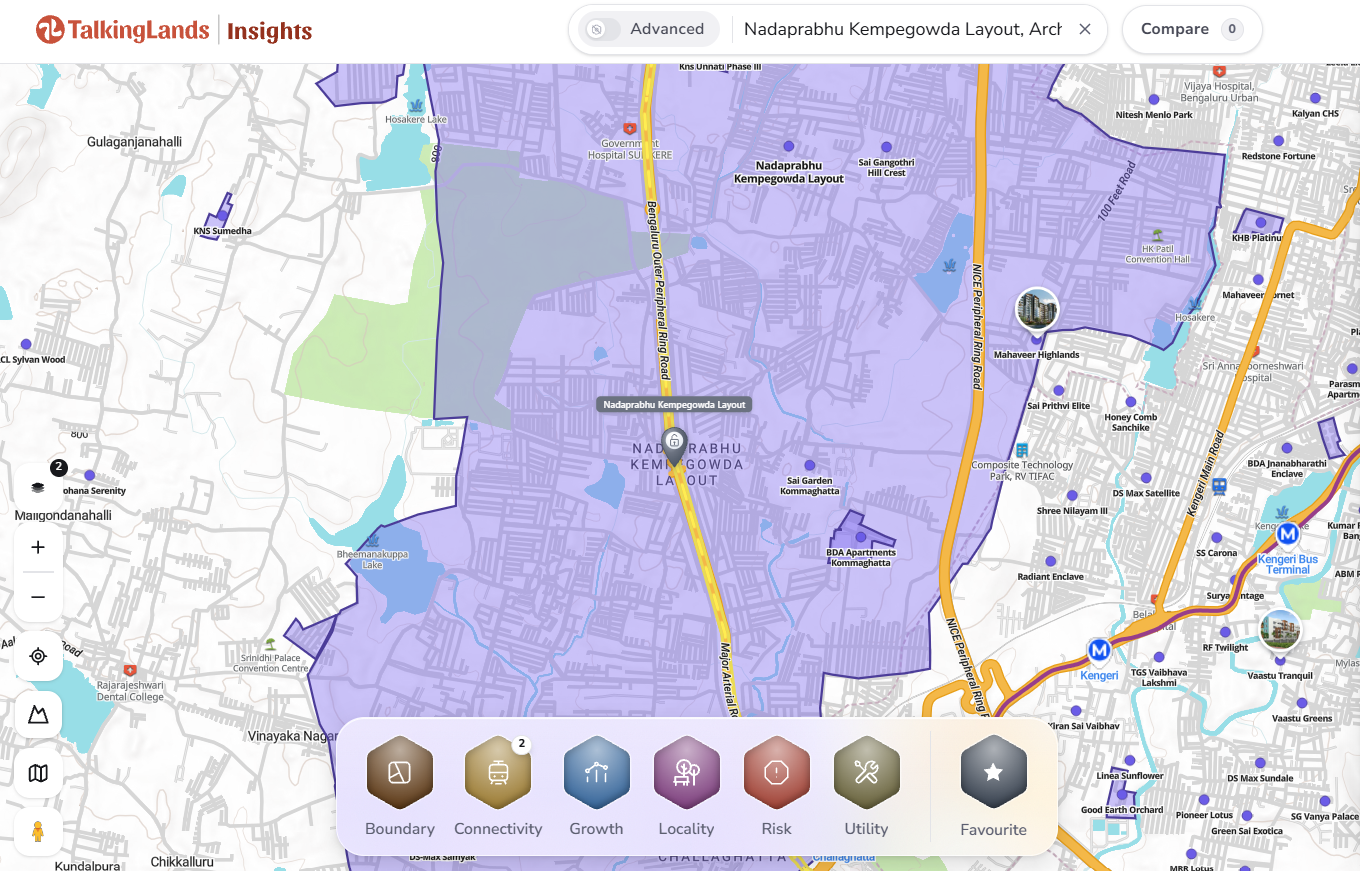

The NPKL stretch: the part already built
The one section of PRR-2 that is already on the ground runs through the Nadaprabhu Kempegowda Layout (NPKL), where it exists today as the Major Arterial Road. This stretch went through its own preliminary notifications and was finally notified and completed years ahead of the rest — and completing it was, in effect, a precondition set by the courts before the wider corridor could advance.
For buyers, NPKL is a useful reference point: it shows what the finished corridor is meant to look like, and it anchors the southern alignment. Land around this completed stretch behaves differently from land where only a notification exists — because here the road is real, not proposed.
What the PRR-2 notification means for land owners and buyers
The impact depends entirely on where a plot sits relative to the line:
- If your plot is inside the acquired corridor: it will be taken for the road. You are in the compensation / TDR process — the value question becomes the acquisition award, not the market rate. Do not build or transact assuming you keep it.
- If your plot is adjacent to the corridor: this is usually the sweet spot — frontage on a future eight-lane road tends to lift value over time, though the payoff is tied to the road actually getting built.
- If your plot was flagged in 2005/2006 but is not in the 2026 list: it is effectively released — a genuine relief that can unlock sale and development that was frozen for years.
Across all three cases, timing is the key caveat. Even with the final notification done, construction of a corridor this size runs over several years, with completion targeted toward the end of the decade. Any "PRR premium" on adjacent land is a medium-to-long-term bet, not an overnight one — and it is real only if the road progresses.
How to check if a plot is on the PRR-2 corridor
Two checks, done together:
- The official record: match the plot's survey number against the BDA final notification (gazette). This is the only way to know for certain whether a parcel is being acquired.
- A fast visual check first: before you chase the gazette for every option, see where the corridor runs relative to a plot on a map.

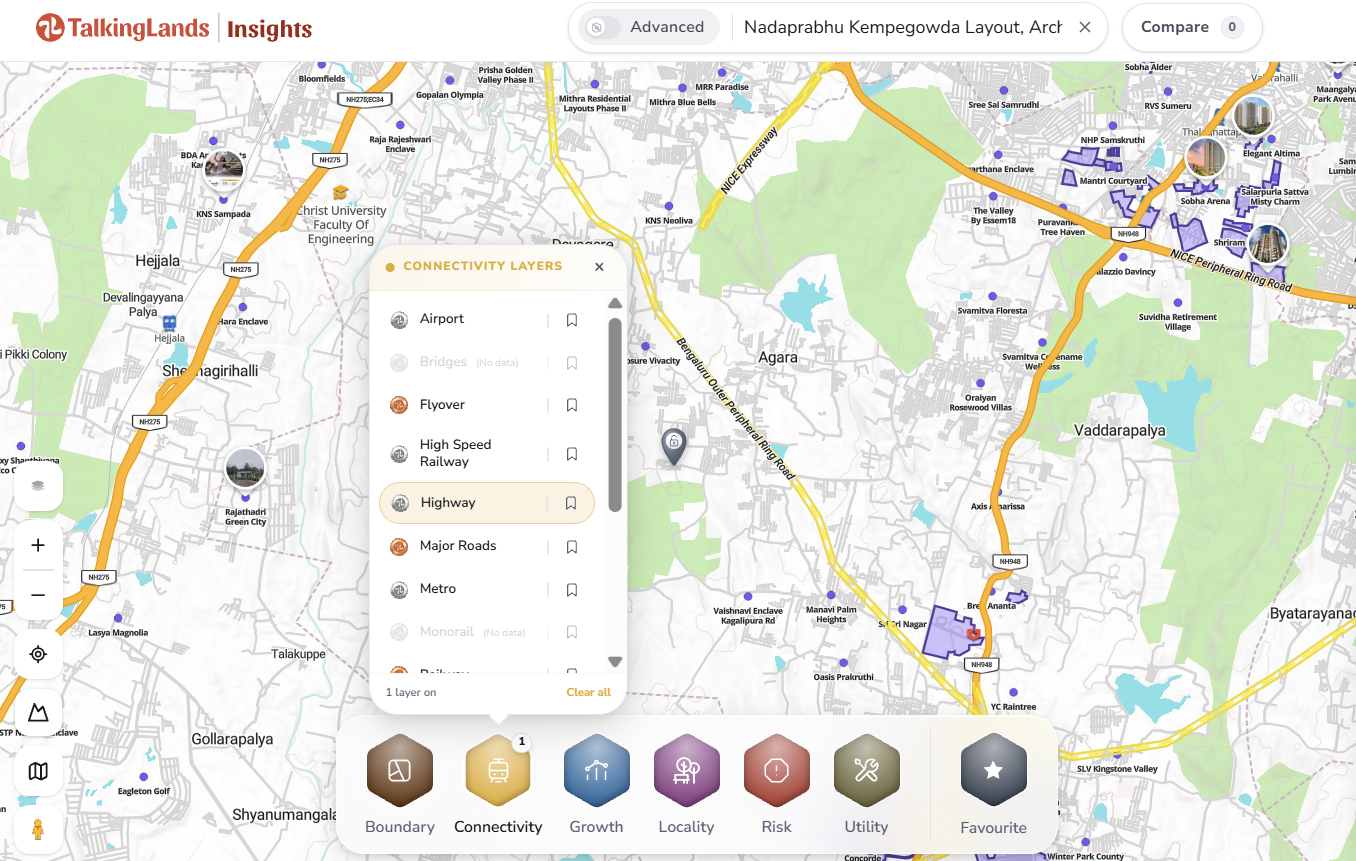

On TalkingLands Insights, open the Connectivity category and turn on the Highway layer to see the ring-road and arterial alignments over a specific location — a quick way to tell whether a plot is on, beside, or clear of the corridor before you dig into survey numbers. Treat the map as an indicative first pass and confirm anything close to the line against the official notification and with a lawyer.
On TalkingLands Insights: open Connectivity → turn on Highway to see the corridor over any plot.
Is Your Plot On the PRR-2 Corridor?
See the PRR alignment and highway layers over any Bengaluru plot on TalkingLands Insights — before you buy or sell. Sign up free, get 5,000 coins, and pull a detailed report from ₹49.
Sign Up Free — Get 5,000 Coins →Frequently asked questions
PRR-2 is a planned eight-lane arterial corridor, part of Bengaluru's ring-road network (Bengaluru Business Corridor). The 2026 final notification covers a roughly 52 km southern stretch linking Mysuru Road with Hosur Road, complementing the northern PRR-1 (Tumkur Road to Hosur Road) to form a ring of about 125 km.
The final notification issued in September 2026 covers about 1,427.34 acres across roughly 31 villages. The road is planned at 65 metres wide within a 100-metre corridor, with eight lanes plus service roads, cycle tracks and pedestrian paths.
The corridor went through preliminary notifications around 2005 and 2006 and faced two decades of land-acquisition disputes, litigation, route changes and funding delays. The 2026 final notification is the step that legally confirms the acquisition, after which awards and compensation follow.
Check your specific survey number against the official BDA final notification (gazette), and use TalkingLands Insights as a first visual check — open the Connectivity category and turn on the Highway layer to see the corridor over a plot. Always confirm parcel-level details with the official notification and a lawyer.
They are two arcs of the same Bengaluru Business Corridor ring. PRR-1 is the northern ~73 km stretch (Tumkur Road to Hosur Road); PRR-2 is the southern ~52 km stretch (Mysuru Road to Hosur Road). Together they aim to form a ~125 km ring around the city.
Disclaimer: This article is general information as of September 2026 and not legal advice. Alignment, acreage and village details are based on the latest available reports and are subject to change and official confirmation. Parcel-level status must be verified against the official BDA final notification (gazette), and landowners should consult a qualified property lawyer before acting.
