Key takeaways
- The Pune Ring Road is MSRDC’s outer ring around Pune and Pimpri Chinchwad, about 169 to 170 km in all, linking the expressway and highways around the city.
- The western stretch from Urse to Varve was about 30 per cent complete in early September 2026, with opening targeted for December 2027.
- The eastern stretch is targeted for December 2028. The 31.8 km south-east link got administrative approval in September 2026, and its land acquisition is only now starting.
- For property, what matters is where your land sits: inside the corridor, near an interchange, or beside the road with no exit.
- Check the 7/12, the zone and the official alignment before you pay a “ring road premium”. The PMRDA draft DP that brokers quote was cancelled.
- TalkingLands Insights shows the ring road over Satbara parcels on one map, with 5,000 free coins at sign-up.
Where is your land relative to the Pune Ring Road?
Pick the case that fits your land. You get what the ring road means for it and the checks to run before you buy, sell or hold.
- Check the 7/12 for an acquisition entry and look up your gat number in the published village list.
- See our village list and acquisition status.
- Get the exact interchange location from the official alignment, not a broker’s sketch.
- Check the zone of the land and the road that links it to the interchange.
- Measure the drive to the nearest interchange, not the distance to the road.
- Check for service roads and underpasses in the final design.
- Watch for acquisition notices for your village.
- Do not buy here until you know whether the land is in the corridor.
Land listings around Pune now lead with one line: “on the ring road”. Sometimes that is true and useful. Sometimes the land is inside the road corridor and will be acquired, or it sits beside the road kilometres from the nearest exit. This guide looks at the ring road from the landowner’s side: where each segment runs, how far along it is, which areas gain access, and what to check. For the full village list, see our Pune Ring Road villages and status page.
What the Pune Ring Road is
The Pune Ring Road, often called the outer ring road, is being built by the Maharashtra State Road Development Corporation (MSRDC) to take through traffic around Pune and Pimpri Chinchwad. A September 2026 report put the total planned length at 168.981 km, and another describes it as a 170 km road linking nine national highways.
- It is an expressway. MSRDC’s 2021 draft environmental study for the western stretch describes a 3+3 lane access-controlled road with a 110 metre right of way.
- It is not the Inner Ring Road. PMRDA runs a separate, closer ring road. Our Inner Ring Road guide covers it.
- Construction began in May 2025 on the western stretch, according to MSRDC’s announcement at the time.
Route and status by segment
MSRDC has split the road differently over the years, so lengths vary by source. This is how the latest reports describe it.
| Segment | From and to | Reported length | Talukas | Status (Nov 2026) |
|---|---|---|---|---|
| West | Urse (Mumbai–Pune Expressway) to Varve / Kelwade (Satara road) | 64.8 to 69 km | Maval, Mulshi, Haveli, Bhor | Under construction, about 30 per cent complete (Sept 2026); opening targeted Dec 2027 |
| East | Urse to Soratapwadi (Solapur road side) | 72.3 km | Maval, Khed, Haveli | Land acquisition reported at about 98 per cent (Nov 2025); completion targeted Dec 2028 |
| South-east link | Soratapwadi (Valti) to Varve Budruk (Shivare) | 31.8 km | Haveli, Purandar, Bhor | Administrative approval Sept 2026; land acquisition starting |
The western stretch runs from Urse past villages such as Pachane, Chandkhed, Pimploli, Ghotawade, Kasar Amboli, Urawade, Mutha, Sangrun, Khamgaon Maval and Kalyan to Varve, through 38 villages in four talukas according to the 2021 draft study. Its biggest works are a 5.8 km tunnel behind Sinhagad Fort, about 80 per cent excavated in September 2026, and a 640 metre bridge at Khadakwasla, expected by August 2027.
The eastern side, per the same study, crosses the old Mumbai–Pune highway near Talegaon, the Nashik road at Kuruli, the Ahmednagar road at Lonikand and the Solapur road near Theur. The south-east link joins the Solapur and Satara highways. It was first planned under NHAI; the state moved it to MSRDC, which must acquire 70 per cent of the land before awarding the contract and hold 90 per cent before the work order. Its approved cost is ₹10,502.36 crore.

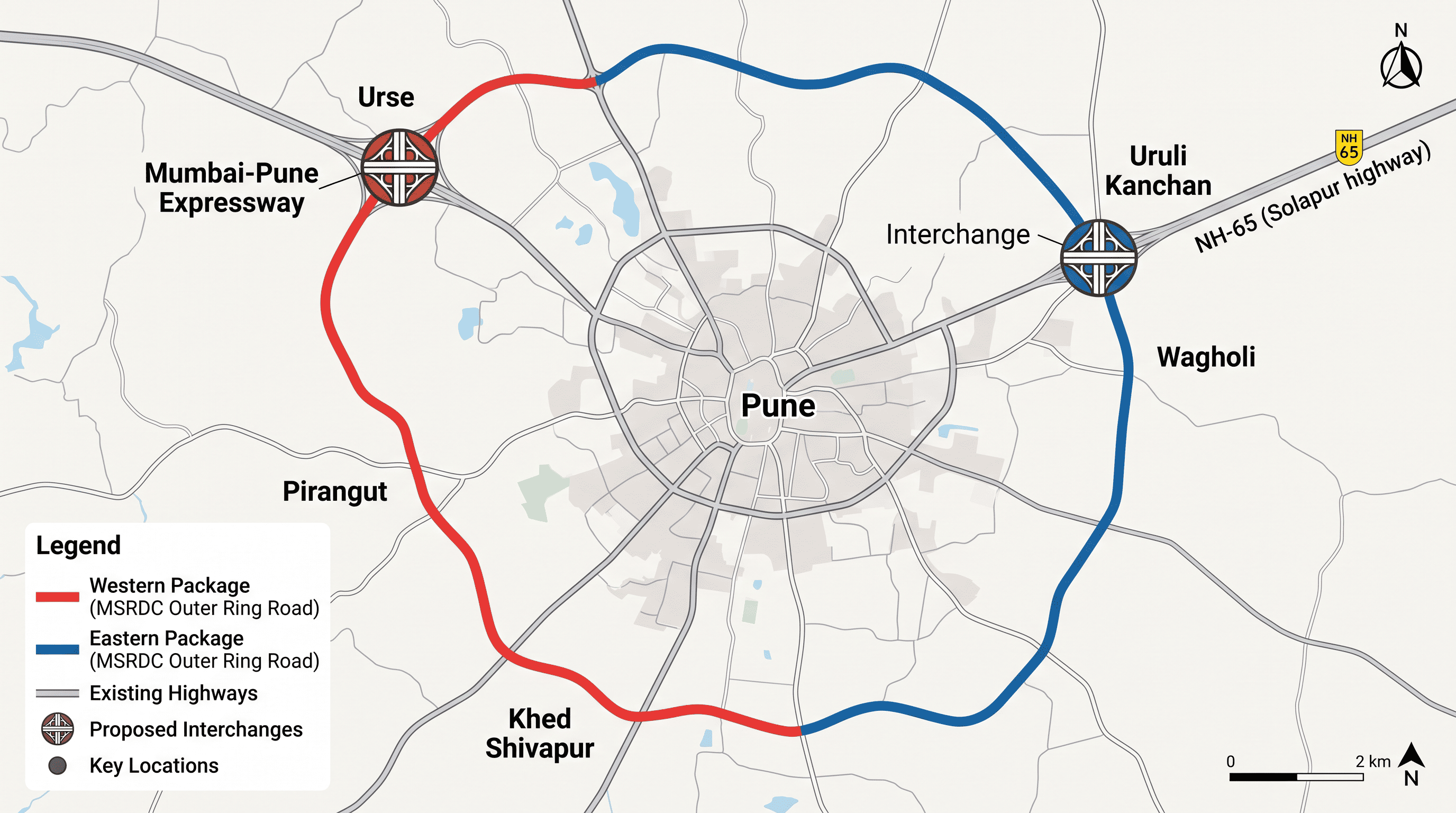

Simplified schematic, not to scale. Positions are approximate; check the official alignment for your gat number.
How the road changes access for property
A ring road does not lift every village it passes. It changes travel time for land that can reach an interchange, and it takes land that lies in its path.
- Interchanges matter most. On an access-controlled road you can only join at interchanges. The 2021 draft study listed six for the western stretch. Land with a short drive to one gains the most new access.
- Through traffic moves out of the city. Trucks heading between the highways can skip central Pune. MSRDC expects the west road to give Hinjewadi a new route towards Mumbai, about 4 km from Phase 3.
- Roadside is not access. Land beside the road but far from an exit gets the noise without the shortcut.
- Zoning decides use. Better access does not change what the land can be used for. The PMRDA draft DP that once showed new zones has been cancelled; see our PMRDA DP 2041 status guide.
Areas along the route
These are the belts the road passes through, from the published route. We do not predict prices; this is about access.
- Maval, near Urse and Talegaon: where the road meets the Mumbai–Pune Expressway.
- Mulshi, around Ghotawade and the Paud road: the west road passes near the Hinjewadi side and Pirangut.
- Haveli and Bhor, around Khadakwasla, Sinhagad and Kalyan: the tunnel and bridge section, ending at Varve on the Satara road near Khed Shivapur.
- Khed, around Kuruli on the Nashik road: close to the Chakan industrial belt; see our Chakan–Talegaon corridor guide.
- Haveli east, around Lonikand and Theur: where the road crosses the Ahmednagar and Solapur roads.
- Purandar and Bhor, on the south-east link: between the Solapur and Satara highways, where acquisition is just starting.
What landowners should check
- Is the gat number in the corridor? Check the published village and survey lists and the 7/12 for an acquisition entry. Our 7/12 extract guide shows how to read it.
- How far is the nearest interchange by road? Use the official alignment, not a brochure map.
- What is the zone? Ask PMRDA or the local planning authority in writing which plan applies now.
- Is there legal access? A road to the land, and whether service roads or underpasses are planned.
- Is the title clean? Have a lawyer check the title, mutation entries and any pending acquisition.
How to check on TalkingLands Insights
- Sign up free on TalkingLands Insights. New accounts get 5,000 coins.
- Search the village and turn on Connectivity → Ring Road to see the alignment.
- Turn on the Satbara parcel layer and zoom in to find your gat number beside the road.
- Add Boundary → Master Plan for zoning colours, and Risk layers such as Notified Lands and Water body. Zoom in if a layer is greyed out.
- Click Get Report, then verify the result with MSRDC, the land acquisition office and a lawyer.
What it shows: the ring road alignment on satellite imagery, parcel outlines from the Satbara layer for covered Pune villages, zoning colours and risk layers around the land.
What it does not show: full ownership for Pune, final interchange designs, or whether your gat number has been acquired. It does not certify title or approvals.

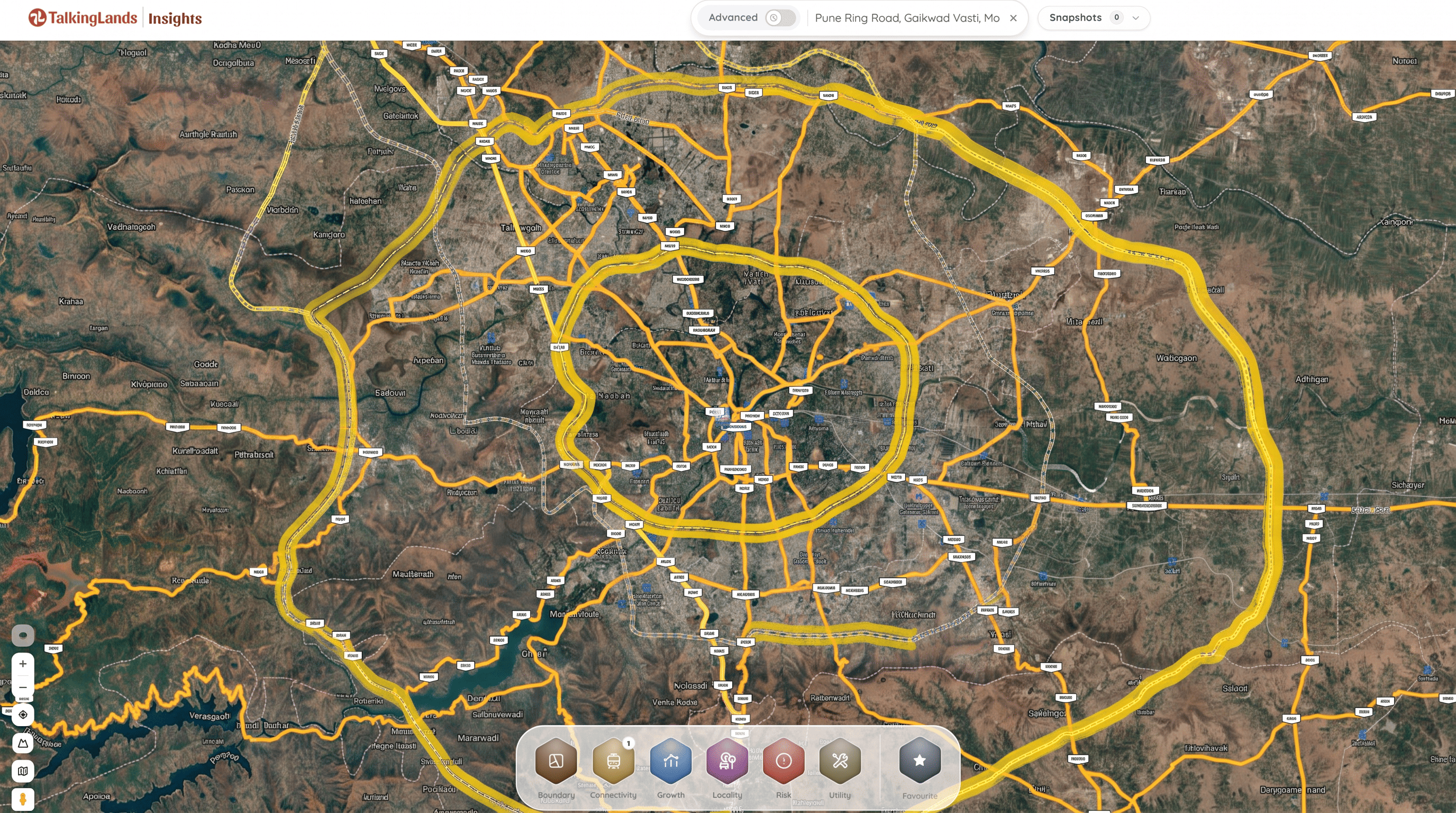

Ring road alignments around Pune on TalkingLands Insights (Connectivity → Ring Road).
Common mistakes
See the ring road over your gat number
Sign up free and get 5,000 coins. Turn on the Ring Road and Satbara parcel layers and see exactly where your land sits.
Sign up freeFrequently asked questions
It is an outer ring expressway around Pune and Pimpri Chinchwad being built by MSRDC, about 169 to 170 km long in all, to take through traffic around the city and link the expressway and highways.
MSRDC's September 2026 update targets December 2027 for the western stretch and December 2028 for the eastern stretch. Earlier targets were different, so treat these dates as targets.
The western stretch was about 30 per cent complete in early September 2026, according to MSRDC, with 65 per cent targeted by December 2026.
The western stretch runs through Maval, Mulshi, Haveli and Bhor. The eastern side runs through Maval, Khed and Haveli, and the south-east link through Haveli, Purandar and Bhor.
We do not predict prices. Access improves mainly for land that can reach an interchange. Land inside the right of way is acquired, and land beside the road far from an exit may not gain access at all.
Check the published village and survey lists, the 7/12 for an acquisition entry, and the official alignment. Our Pune Ring Road village page lists the villages. On TalkingLands Insights you can see the alignment over Satbara parcels.
No. The Inner Ring Road is a separate PMRDA project closer to the city, tied to its town planning schemes. The outer ring road is built by MSRDC.
Updated 5 November 2026. This guide summarises MSRDC documents and news reports on the Pune Ring Road. Lengths, targets and acquisition figures differ between sources and can change. We do not predict prices. This is general information, not legal advice or investment advice; confirm with MSRDC, the land acquisition office and a property lawyer.
